The Battery Coastal Resilience
Rebuilding The Battery's deteriorating wharf promenade about five feet higher, designed for the sea levels projected for 2100. The northern and western two-thirds was finished in March 2026, and the mayor marked its completion in June; the southern and eastern third is closed for Phase 2, scheduled to run to June 2027.
The Battery, 1928 and 1936
The Battery's waterfront long before this project: from the air after a snowstorm, and its fireboat house eight years later.


The budget over time
Each point is a public statement of the project's estimated cost, from the agency or from official documents and press coverage of them.
View this data as a table
| Date | Estimate | Context | Source |
|---|---|---|---|
| Mar 2019 | $165,000,000 | Announced in the citywide Lower Manhattan resiliency plan | preventionweb.net |
| Mar 2021 | $129,000,000 | Concept design unveiled; figure appears to cover construction only | stantec.com |
| Sep 2022 | $165,000,000 | City capital funding, per Rebuild by Design's ten-year update | rebuildbydesign.org |
| Jun 2023 | $169,000,000 | Pre-construction budget baseline | ebroadsheet.com |
| May 2024 | $200,000,000 | Groundbreaking figure, $31M over the baseline | nyc.gov |
The schedule
The construction window announced when the project was unveiled, against the current public schedule. Below the bars, the features the project promised, each with the date promised at announcement and the date it actually arrived, if it has.
Promised versus delivered
What was promised
- The wharf promenade rebuilt about five feet higher, to roughly 11 feet above mean sea level, designed for 2100 sea levels
- Construction starting in late 2022 and finishing in winter 2024
- Ferry service to the Statue of Liberty and Ellis Island maintained throughout construction
- Materials moved by barge, cutting more than 2,000 truck trips and over half the embodied carbon
- Phase 1 reopening by October 2025, per later construction commitments
What happened
- keptPhase 1, the northern and western two-thirds of the wharf raised five feet, was complete in March 2026, according to the city's March 16 update to Community Board 1; the mayor announced its completion on June 8, 2026
- keptBarge logistics delivered, with the promised cut in truck trips and embodied carbon
- changedConstruction began in January 2024, when the Phase 1 fence went up, more than a year after the late-2022 start forecast in 2021; the groundbreaking ceremony followed on May 6, 2024
- changedCost rose from the $169M pre-construction baseline to $200M
- changedPhase 1 was finished in March 2026, about five months after the October 2025 target in the city's own schedule
- pendingPhase 2, the southern and eastern third of the promenade, began in March 2026 and is scheduled to run to June 2027
- changedThe new ferry-screening facility, which The Broadsheet reported was bought from a supplier in Germany and delayed Phase 1, went into service beside Castle Clinton on March 6, 2026. Screening stays on the waterfront by design: the city's project FAQ says it returns to the Castle Clinton area and calls moving it elsewhere a long-term goal of the Park Service and the city

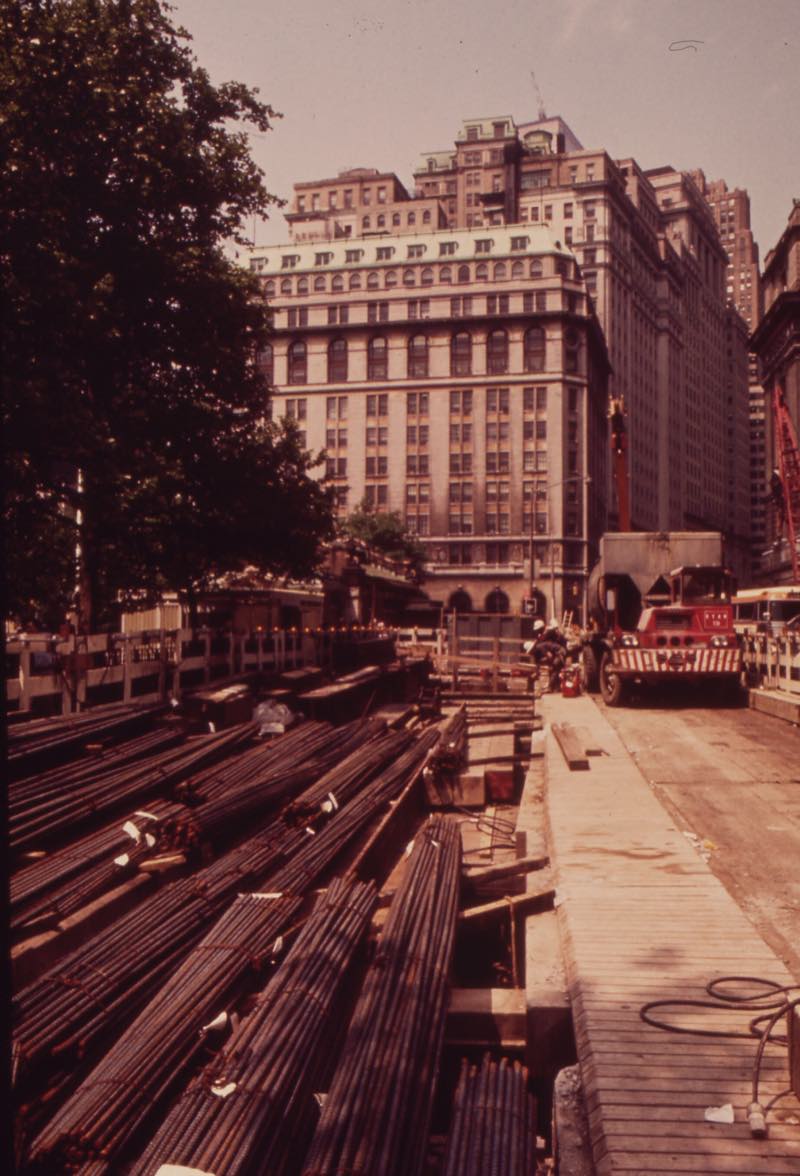

A construction site before
The Battery in May 1973, photographed for the EPA's Documerica project.


Friction and open questions
Disputes, community objections, and unresolved issues on the public record.
-
In March 2026 the National Park Service commandeered the newly reopened waterfront for ferry security operations, drawing criticism until it agreed to give back portions of the space.
Phase One Done, The Broadsheet, Jun 2026
-
The project's public cost figures have shifted basis over the years, from $165M to $129M to $169M to $200M, making the true overrun hard to state precisely. We show every figure and its date.
Phase One Done, The Broadsheet, Jun 2026
- Unlike the BPCA projects, this project has no board record, and the city's own project pages are thin and stale: in October 2026 the main page still says Phase 1 'will conclude in 2025', its construction notices stop at February 2025 and its presentations at July 2024, and the program-level resources page holds only planning-era RFPs and memos. Quarterly newsletters are the one regular document; the eighth, in June 2026, announced Phase 1 complete. The record on this page is assembled from city presentations to Community Board 1, press releases, those newsletters, and reporting.
Sources
- Official project page
- The Battery Coastal Resilience, official LMCR project page
- Mayor Adams breaks ground on Battery Coastal Resilience, NYC Mayor's Office
- Mayor Mamdani completes first phase of Battery Coastal Resilience, NYC Mayor's Office
- Phase One Done, The Broadsheet
- Stantec unveils concept for $129M Battery Coastal Resilience project
- The Battery Coastal Resilience ten-year update, Rebuild by Design
- Mayor de Blasio announces Lower Manhattan resiliency plan
- First phase of Battery Coastal Resilience completed, amNewYork
- Lower Manhattan Coastal Resiliency update to Manhattan CB1, March 16, 2026: Phase 1 complete March 2026, Phase 2 March 2026 to June 2027
- New Security Screening and Ferry Location at The Battery, National Park Service
- Battery Coastal Resilience newsletter 8, June 2026, NYC LMCR
- Battery Coastal Resilience construction FAQ, NYC LMCR: screening returns to the Castle Clinton area
- Battery Coastal Resilience construction notification, January 9, 2024: Phase 1 fencing from January 15
- Lower Manhattan Coastal Resiliency update to Manhattan CB1, October 20, 2025: Phase 1 to October 2025
