The pavilion's missing restaurant

documented South BPC Resiliency Wagner Park

The rebuilt Wagner Park pavilion was promised with a restaurant, classroom, public restrooms, and a public rooftop. Every one of those arrived late or has not arrived. This page assembles the record of the building at the center of the park, from the last meal served in the old one.

4 summers

since Gigino closed on September 5, 2022, with no opening date for the new restaurant as of October 2026

The lawn, drawn and built

The rendering the BPCA showed Community Board 1 in September 2022, and the park three days after it reopened in part, its pavilion still behind barriers.

Rendering of a sunlit Wagner Park lawn under full-grown shade trees, a child cartwheeling and people picnicking and strolling across the grass
The lawn as the BPCA presented it to Community Board 1 on September 20, 2022: a rendering from the agency's own deck.
The rebuilt Wagner Park lawn under a grey sky, the new rust-red arched pavilion behind orange and white barriers and a Pardon Our Appearance sign, the Museum of Jewish Heritage at left and One World Trade Center beyond
Wagner Park on August 1, 2025, three days after it reopened in part.

The sequence

  1. Sep 5, 2022

    Gigino at Wagner Park serves its last meal after 23 years in the old pavilion. Tribeca Citizen reports the operator will not necessarily return after the rebuild.

  2. Sep 2022

    In the BPCA's design presentation to CB1's Environmental Protection Committee, the preliminary First Place design's glass-top floodwall is revised out of the final submission, replaced by movable planters and salvage-stone elements: an early, documented case of a glassy promise becoming something more utilitarian.

  3. Nov 16, 2022

    The park closes, with the whole project promised complete in roughly two years.

  4. May 2024

    With reopening promised for 2025, the BPCA issues an RFP for a restaurant operator: a ten-year lease on 5,000 square feet with roughly 80 seats.

  5. Nov 2024

    The first RFP draws zero responses. A relaunched RFP adds renderings, site visits, and flexible rent.

  6. Jun 2025

    The operator emerges: food-services firm Jabber Dorado, whose public-facing brand is the fast-casual Migrant Kitchen.

  7. Jul 29, 2025

    The park reopens, a year late. The pavilion is entirely closed: no restrooms, no classroom, no rooftop, no restaurant.

  8. Sep 4, 2025

    In a presentation to CB1's Battery Park City Committee, the BPCA names Jabber Dorado Enterprises as the proposed operator and estimates six to nine months of fit-out from November 2025, with the restaurant opening in summer 2026.

  9. Nov 10, 2025

    The BPCA unveils the pavilion rooftop and its observation deck, with restrooms open, the classroom promised for early 2026, and the restaurant promised for summer 2026.

  10. Mar 4, 2026

    The BPCA's board update schedules turnover of the restaurant space to the operator for mid March.

  11. Mar 24, 2026

    The BPCA unveils the classroom and community space, and its release says a restaurant will open in the pavilion "this summer."

  12. Jun 3, 2026

    The BPCA's board update lists the restaurant as turned over, without a date.

  13. Sep 24, 2026

    The BPCA declares the South BPC project complete. Its release names the park's reopening, the rooftop and the classroom as milestones and does not mention the restaurant.

  14. Oct 2026

    No opening date has been announced, and summer 2026, the target the BPCA last stated, has passed. A 2027 opening would make five years since the old restaurant closed.

The park around it

Wagner Park's lawn in 2007, and the rebuilt park's path along the water in August 2025.

Wagner Park's lawn in late summer sun, framed by a tree's dark branches, with Pier A's clock tower beyond and a walker on the waterfront path at right
Wagner Park's lawn in August 2007.

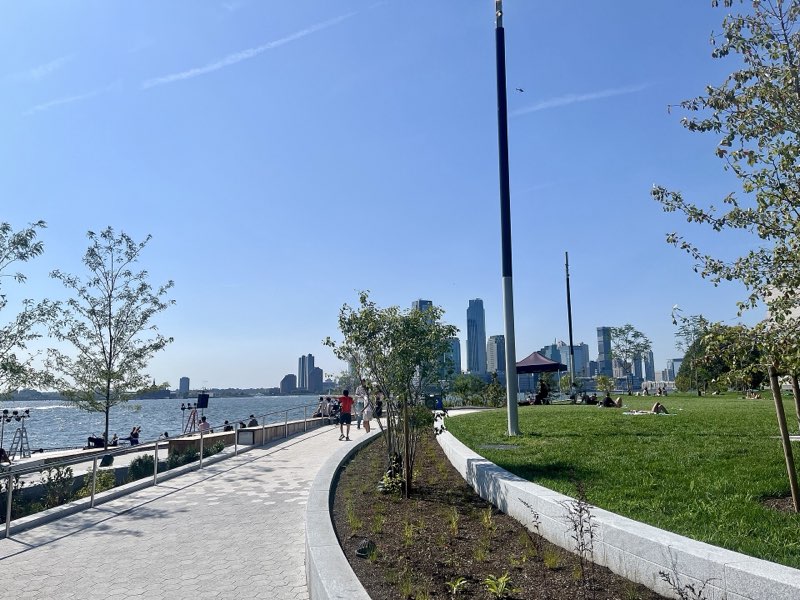

The rebuilt Wagner Park's waterfront path on a clear day, young trees in a new planting bed and a granite curb between the path and the lawn, people on the grass and the harbor at left
The path along the water, August 2025.

Still being assembled

  • resident-observed The building in use: rooftop and restroom doors that auto-lock at dusk in what was promised as open public space, glare and heat through the untinted glazing, moisture rising in the lawn, and water in the basement. Dated photos and readings to come.
  • needs source The observation area's original glass-topped treatment versus the metal grating installed near Pier A. The September 2022 First Place revision is the closest documented parallel; the Pier A change is being traced through design documents in the archive.
